Skip to main content
Beebole’s billing rates turn tracked time into revenue figures. You define what an hour, a day, or a piece of work is worth, and Beebole calculates billable amounts from the time your team logs — ready to analyze in reports and to measure against budgets.
Billing rates are available on paid Beebole plans. Who can view and edit them is controlled by the Billing rates permission — see Roles & permissions.

Billing methods

Each billing rate uses one of four methods:
MethodWhat it means
Hourly rateA fixed amount per hour worked
Daily rateA fixed amount per day worked
Fixed feeA flat amount, regardless of time spent — optionally repeating
Non-billableNo billing amount is calculated for the time covered by this rate

Where to set billing rates

Billing rates live in the Billing section of the organization, tag, project, or person settings panel. You can set them at four levels: organization, tag, project, and person.
LevelTypical use
OrganizationA company-wide default rate
TagA default for everything under the tag — a department or a client group, for example
ProjectA rate negotiated for one project, including its subprojects
PersonA rate tied to one person, such as a contractor
To open the Billing section at each level:
  • Organization — click the button with your initials at the bottom of the sidebar, then go to Settings > Account Settings.
  • Tag — click Tags in the sidebar, then the tag’s name.
  • Project — click Projects in the sidebar, then the project’s name.
  • Person — click People in the sidebar, then the person’s name.

Adding a billing rate

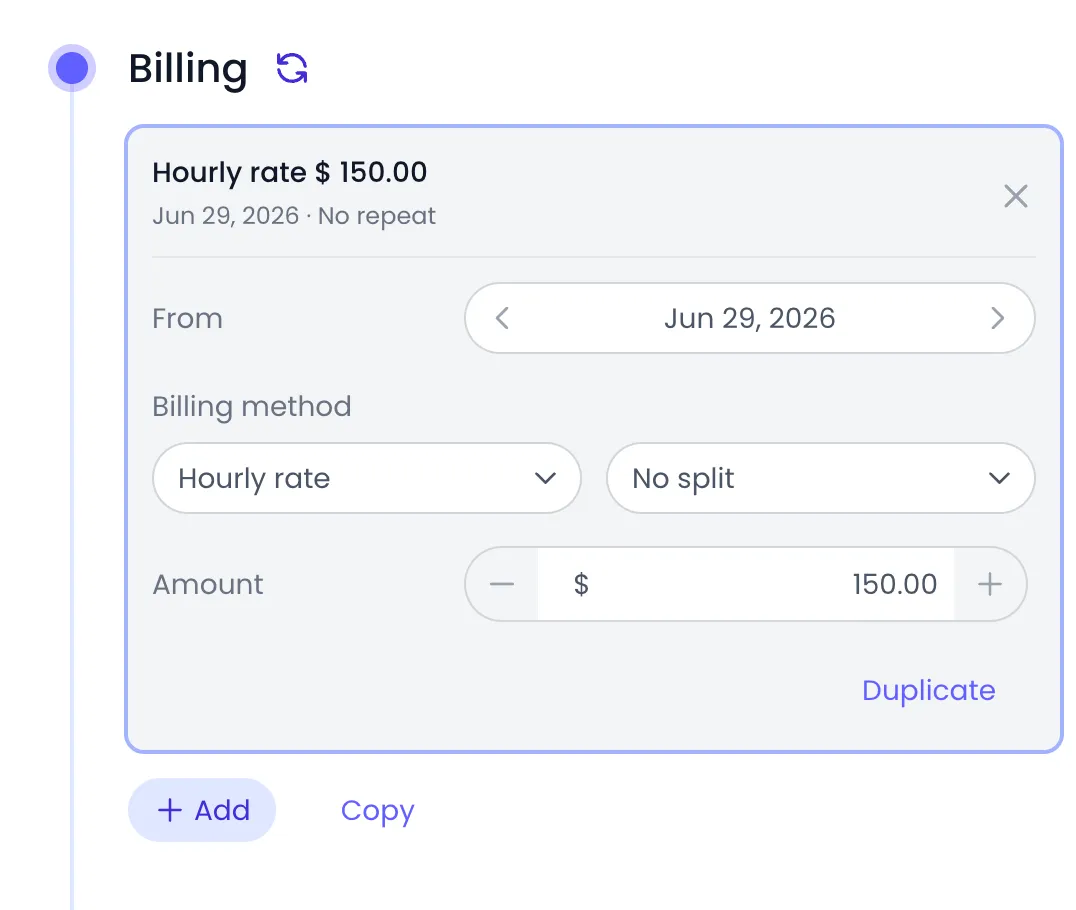

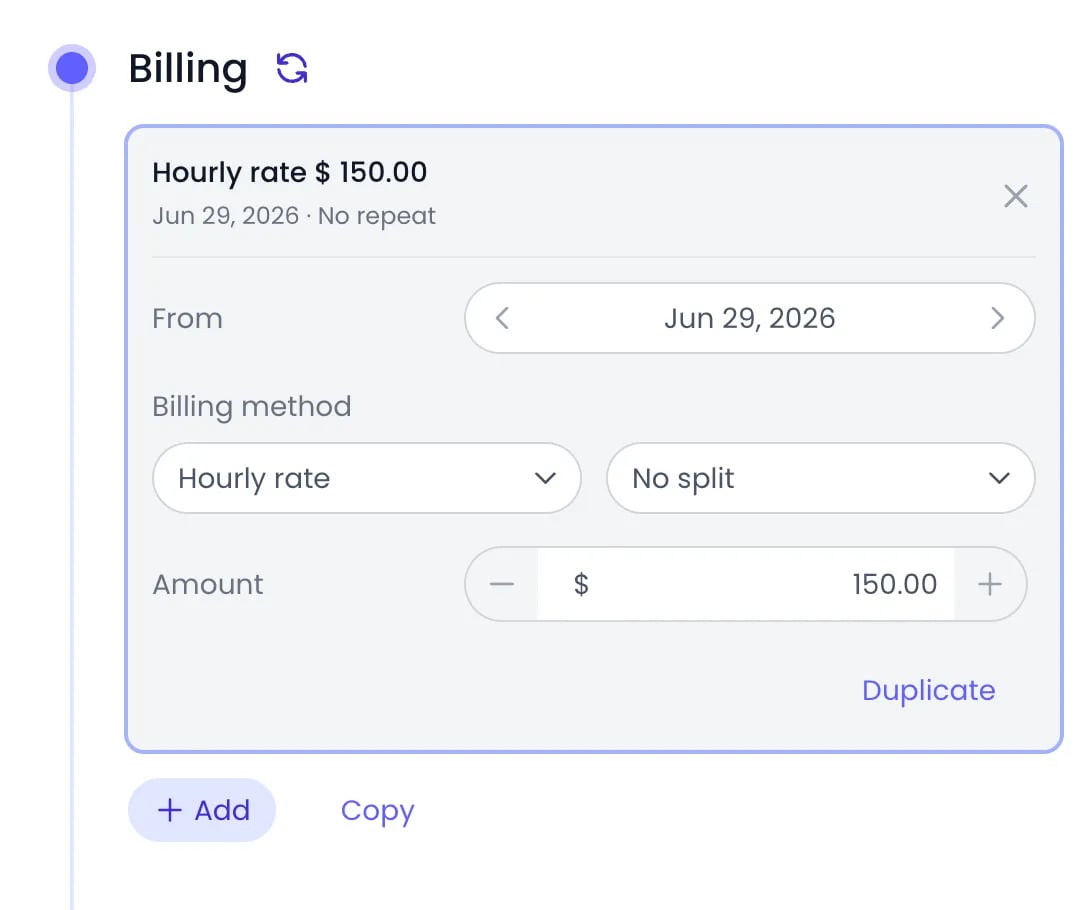

1

Open the Billing section

In the settings panel, scroll to Billing.
2

Add a rate

Click Add to create a new billing rate.
3

Set the start date

Pick the From date — the date the rate takes effect.
4

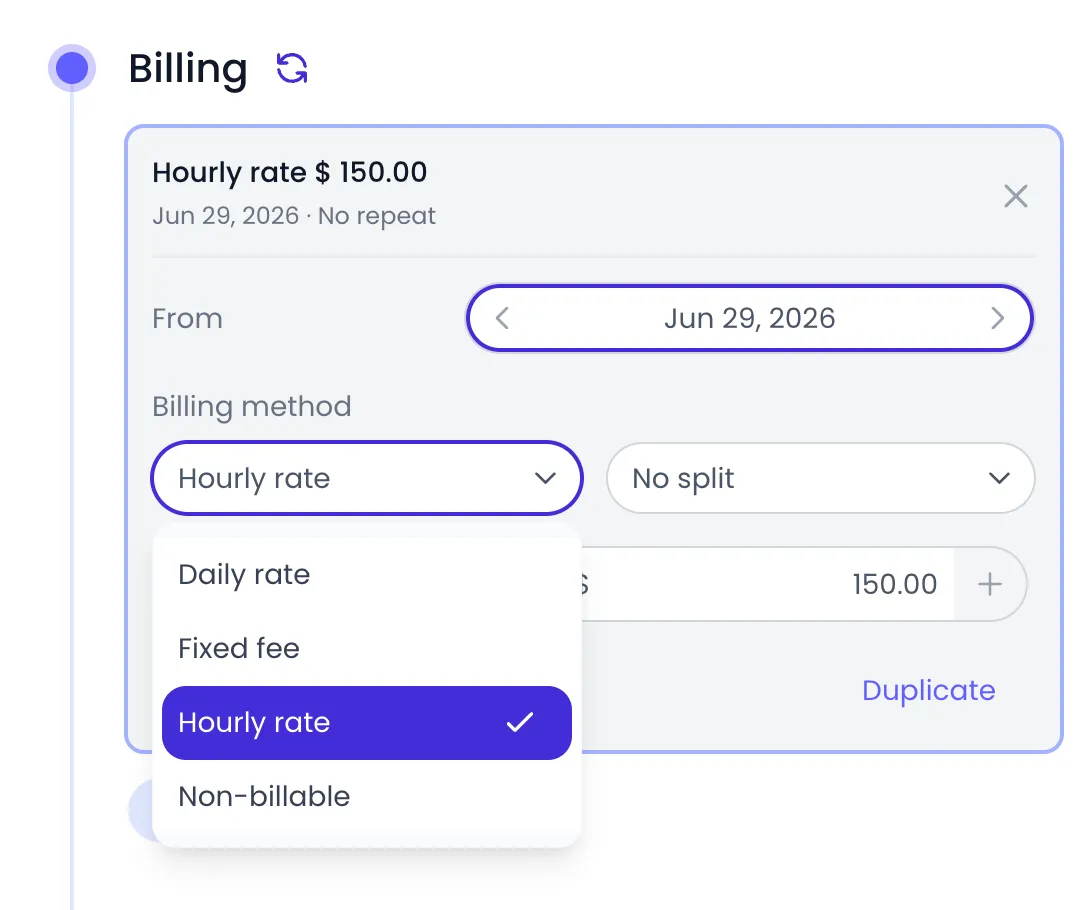

Choose the method and amount

Select a Billing method and enter the Amount with its currency. Changes are saved automatically.

Rates set on the organization or on a tag cascade down: a project or person without its own rate shows the rate it inherits. Adding a rate directly on the project or person overrides the inherited one.

Which rate applies to a time entry

When several billing rates could apply to the same time entry, the most specific rate wins. For each entry, Beebole looks for a rate in this order:
  1. The project the time was logged against — starting at the deepest subproject and walking up the project hierarchy.
  2. The person who logged the time — used when no project in the chain has a rate.
Rates inherited from tags or from the organization count as the rate of the project or person they cascade to, so a company-wide default still applies through this same lookup. Billing rates cannot be set directly on a task; time tracked on a task is billed through the project and person rates above.

Rate splits

With an Hourly rate or Daily rate, you can replace the single amount with a separate amount per person or project. The split options are:
  • No split — one amount applies to everyone.
  • Split by persons — a separate amount for each person you add to the list. Available on organizations, tags, and projects.

  • Split by projects — a separate amount for each project you add to the list. Useful on a person or tag whose work is billed differently per project.
Each row in a split has its own Amount, and a Non-billable checkbox to exclude that person or project from billing entirely.

Changing rates over time

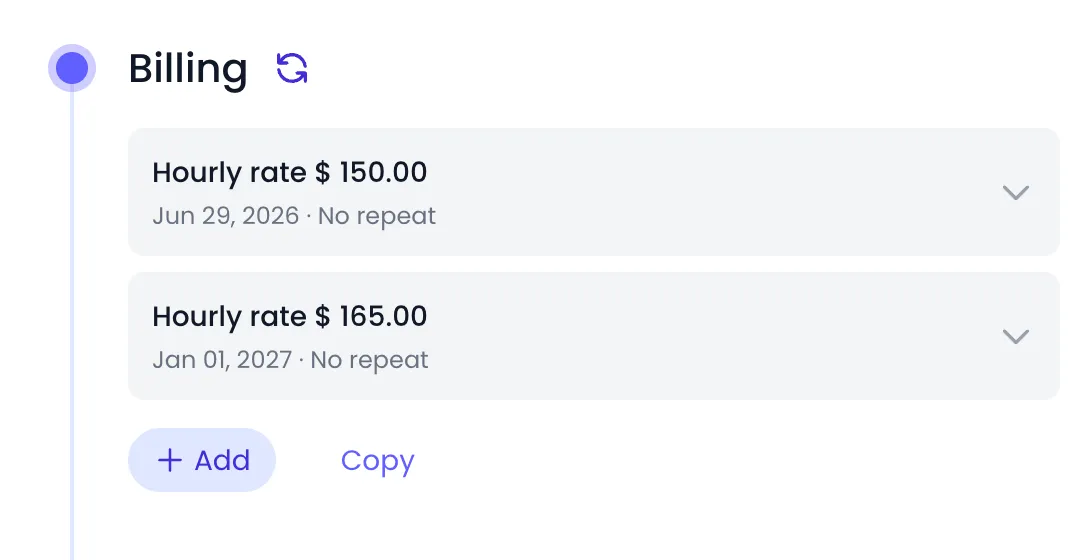

Each billing rate has a single From date. The rate applies to time entries dated on or after that date, until a rate with a later From date takes over. To raise a project’s rate from January 1, add a new rate starting January 1 — entries before that date keep the old rate, with no recalculation needed. You can also click Duplicate inside a rate card to copy an existing rate as the starting point for the new one.

Recurring fixed fees

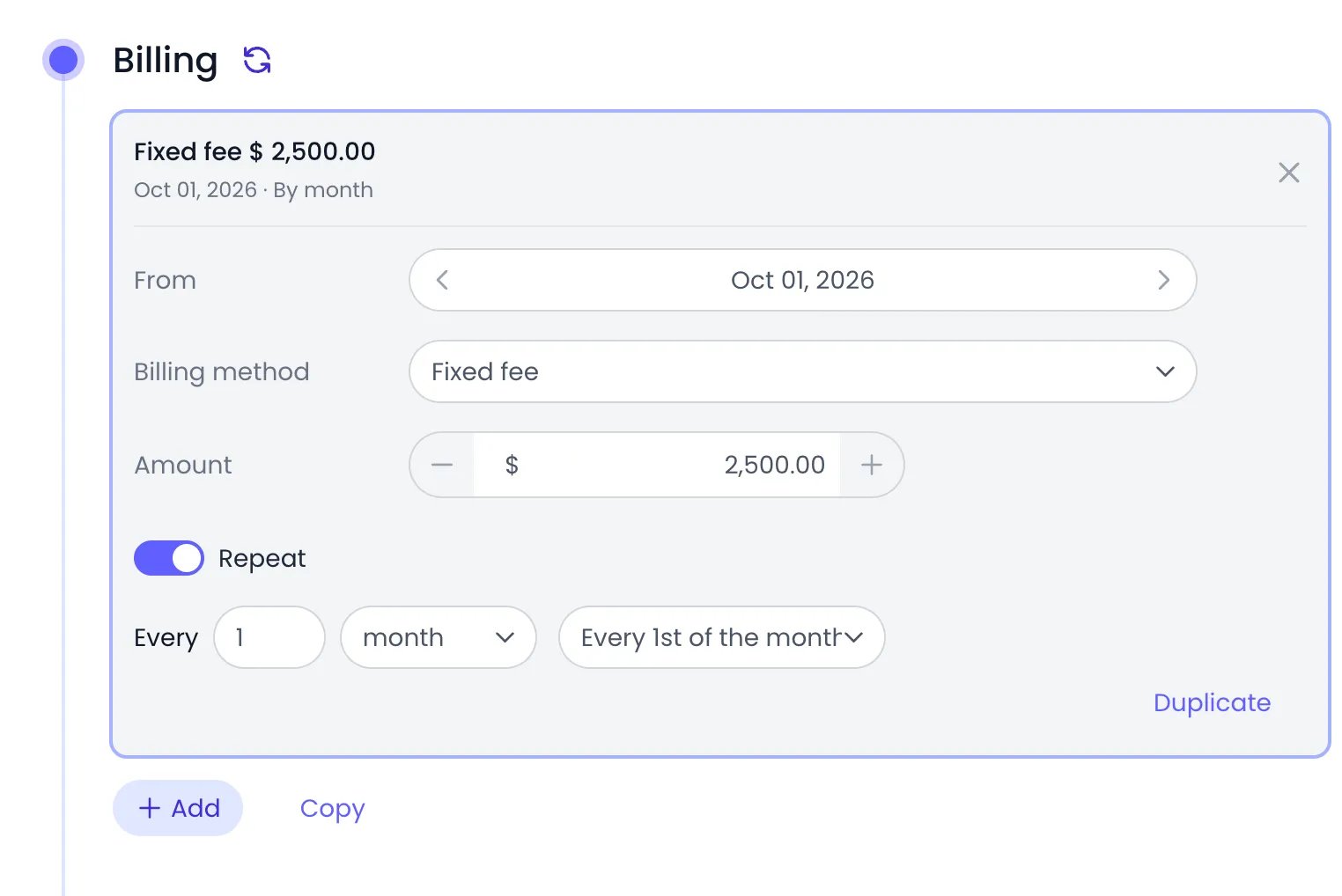

A Fixed fee applies once. To bill it repeatedly — a monthly retainer, for example — turn on Repeat in the rate card and choose how often it recurs: Every 1 or more days, weeks, months, or years. Choose End to stop the repetition on a given date, or Do not end to let it run indefinitely.

Billing in reports

Tracked time is multiplied by the resolved rate and shown in reports. In a custom report, add the Billing column to see billable amounts, and group by project, person, tag, or period to analyze revenue from any angle. When cost rates are configured too, the Margin column shows billing minus cost.

Cost Rates

Track what the same work costs you internally and measure margins.

Budgets

Set billing, cost, and hours targets on projects and monitor progress.

Custom Reports

Build reports with billing and cost columns, grouped and filtered your way.

Projects

Create and organize the projects and subprojects your team bills time to.

Frequently asked questions

Beebole calculates no billing amount for that time. The hours still appear in reports, but the Billing column stays empty for those entries until a rate at some level applies to them.
Yes. Set a billing rate on each project — project rates take priority over the person’s own rate in Beebole. On a single project, use Split by persons to give each team member their own amount.
No. In Beebole, billing rates are set on the organization, tags, projects, and people. Time tracked on a task is billed through the rate of the project it was logged against, or the person’s rate.
Add a new rate with a From date set to when the change starts. Beebole applies each rate only to time entries dated on or after its From date, so earlier entries keep the previous rate.
Choose the Non-billable billing method on the relevant project, person, or tag, or tick the Non-billable checkbox next to a person or project inside a rate split. Beebole then calculates no billing amount for that time.
