How approval works
- A person completes their timesheet and clicks Submit at the top of the page. The button appears only when an approval workflow applies to them. The timesheet locks and enters the first approval stage.
- The stage’s approvers are notified. Depending on the stage’s quorum, either any one of them or all of them must approve.
- Once the stage is complete, the timesheet advances to the next stage, whose approvers are notified right away. When the last stage approves, the timesheet is Approved and its owner is notified.
- If any approver rejects — a comment is always required — the timesheet becomes Rejected and returns to its owner, who is notified with the reason and can correct it, then click Resubmit.

The stage breakdown of a submitted timesheet, opened from its badge in the Team pane
Configuring the approval workflow
The workflow is a list of sequential stages. It lives in the Approval workflow panel, which exists at three levels: your organization’s Account Settings, every tag, and every person’s profile. Like other cascading settings, the most specific level wins — a workflow set on a person overrides one set on their tags, which overrides the account default. An icon next to the panel shows where the current workflow is inherited from. A workflow set on a tag applies to everyone under that tag, so each team can follow its own sign-off process.Open the Settings menu
Go to Account Settings
Open the Approval workflow panel
Add a stage
Choose the stage's type and quorum
Add and order more stages (optional)

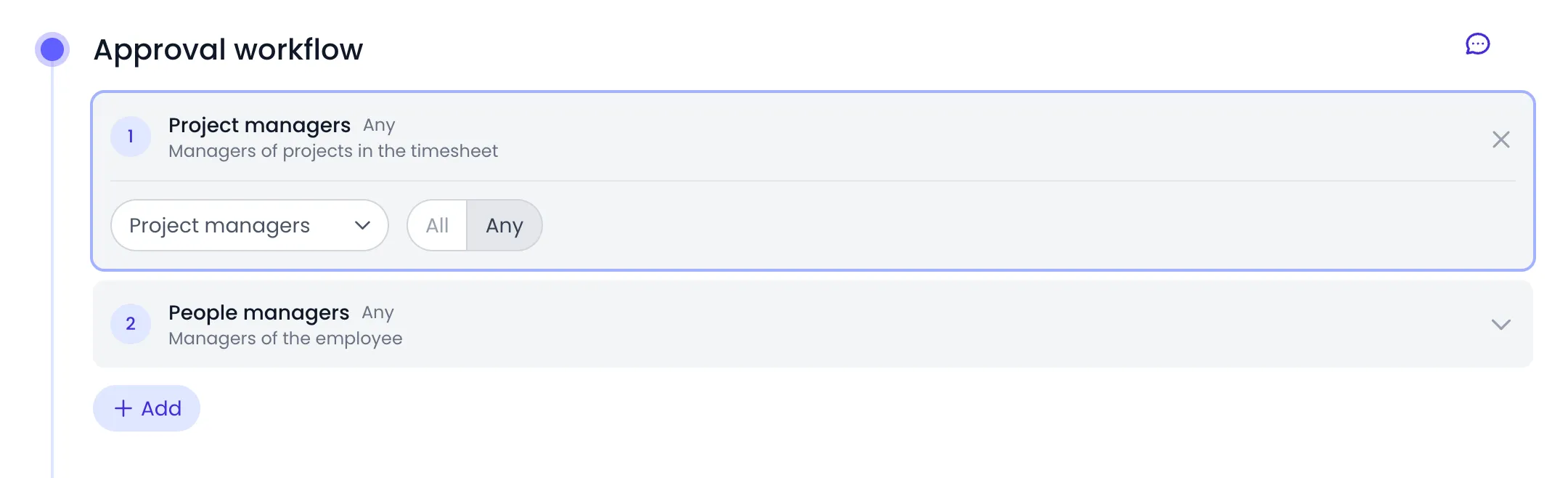

A two-stage workflow: the project managers, then the person's managers
Approver types

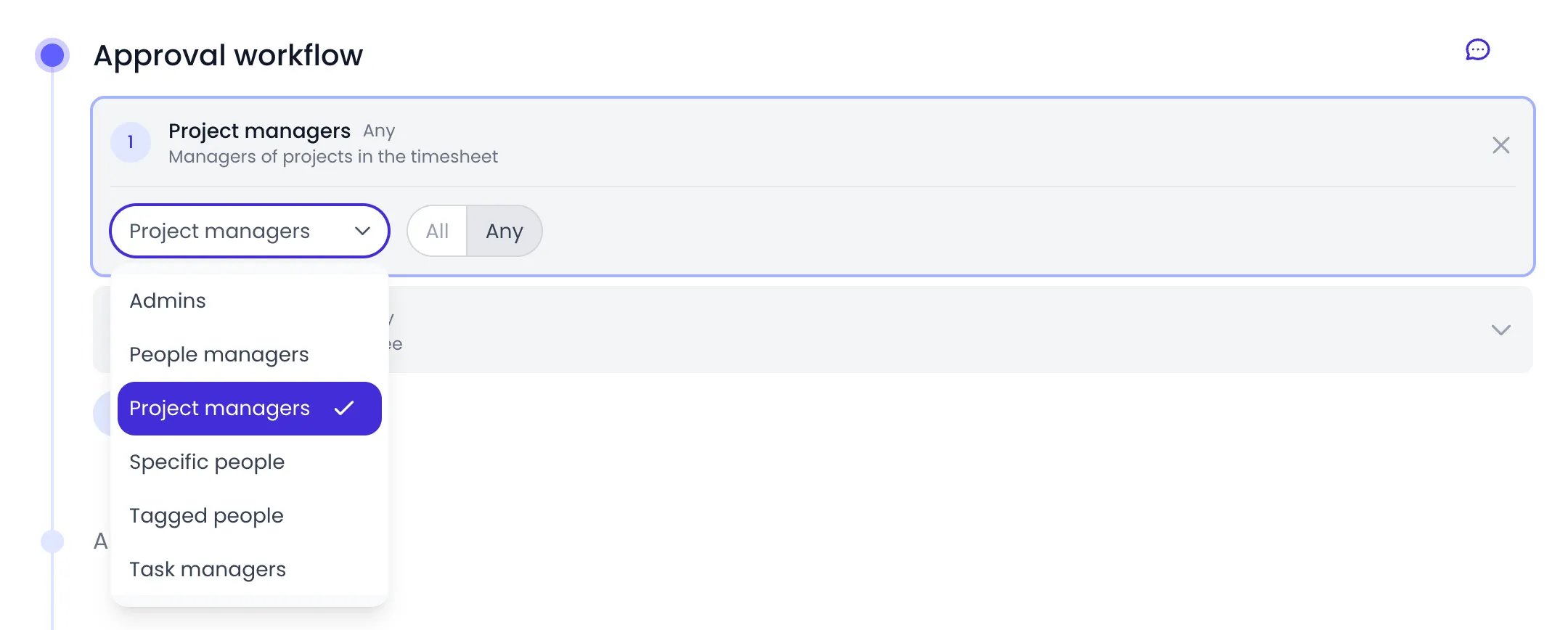

A stage's approver type, picked from the six types
Reviewing and approving your team’s timesheets
Approvers can act from four places: the Timesheet page, the Journal, directly from email, or from a phone.From the Timesheet page
Managers and administrators see an approval button (Approval) in the button cluster at the top-left corner of the timesheet, in either view, with a red badge counting submissions waiting for them. It opens the Pending pane:- The pane lists each timesheet waiting for your approval, with Late submissions grouped at the top. Administrators and people who manage people also get a Show all switch. It adds the waiting timesheets of everyone below you in the management chain, and the ones you may decide in an approver’s place. For an administrator, it shows every waiting timesheet in the organization.

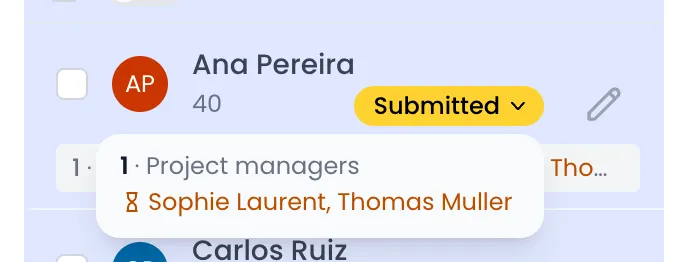

- Click a person to open their timesheet for the submitted period. Approve and Reject appear at the top of the timesheet only when you may decide its current stage: as one of its pending approvers, in an approver’s place (see Stepping in for an approver), or as an administrator. A timesheet that Show all adds can wait for someone you can’t stand in for, such as a project manager who isn’t below you in the management chain: you can open it, but not decide it.
- Once you open a timesheet you may decide, the pane flags anything unusual in its period under the person’s row, such as Time on a non-working day or More time than scheduled. See Approval review.
- Select several submissions with the checkboxes to act in bulk with Approve and Reject. Only the timesheets you may decide are approved or rejected, and the others stay as they are.

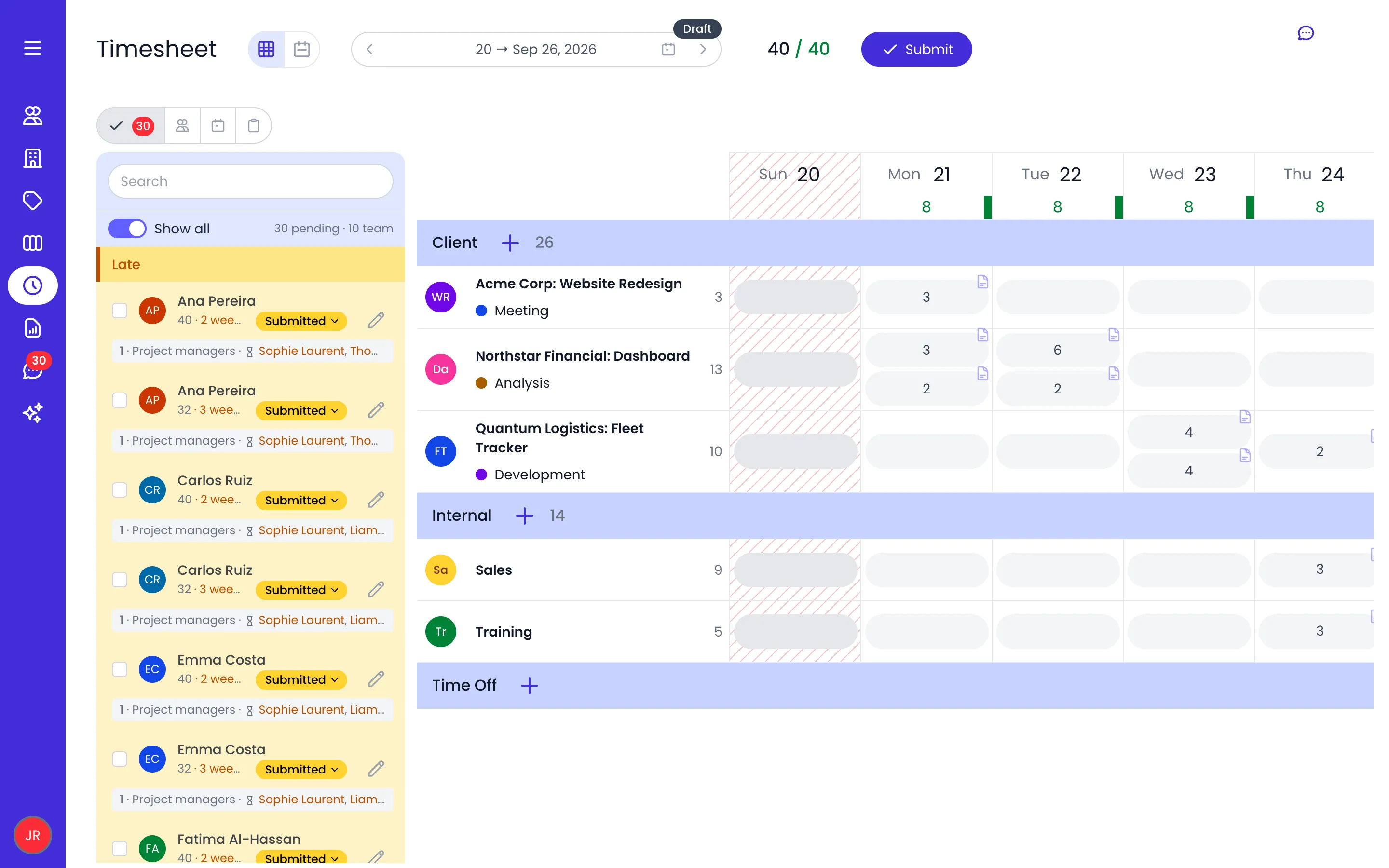

The Pending pane with Show all on, late submissions first
- Approve and Reject act on the selected timesheets submitted for the period on screen that you may decide: those waiting for you, those you may decide in an approver’s place, and, as an administrator, any submitted one.
- Remind goes to the selected people who have an approval workflow and whose period is a draft (empty or not) or rejected. People without a workflow have nothing to submit, so they are skipped, and people whose timesheet is approved, or submitted and waiting for someone else, are never reminded. Once the reminders are sent, those people are deselected and the submitted ones stay selected for approval.

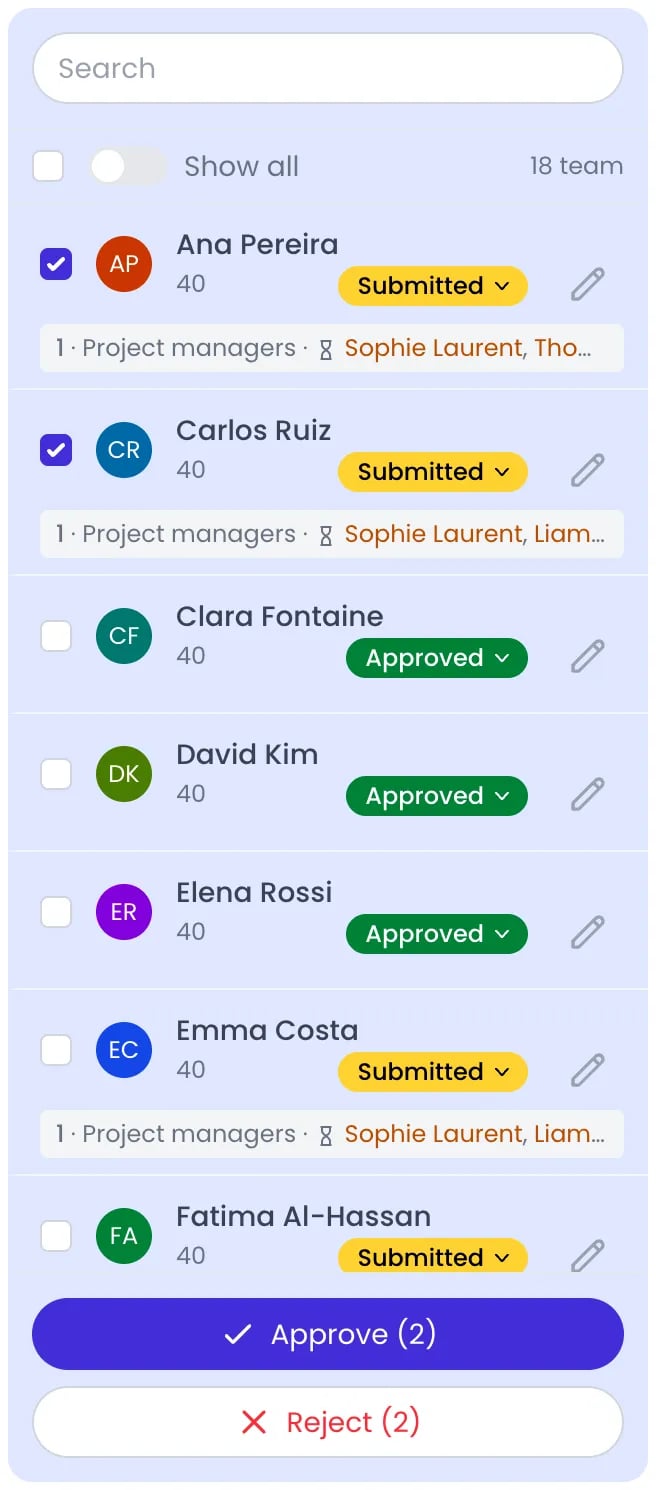

Two submitted timesheets selected in the Team pane
From the Journal
Click Journal in the left sidebar. Approvers see a banner at the top of the feed — 1 timesheet to approve, or the total count — or All caught up when nothing is waiting. Expand the banner to review without leaving the page:- Each pending submission shows its total Hours and Billing amount — plus Cost, if your role can see costs.
- Click a person’s name to split their total by project, task, and absence type, or click View records for the day-by-day entries with their comments.
- Approve or reject one row, or select several and act in bulk.
From your email
Approval notification emails, and the approval reminders that follow them, include a summary of the submitted timesheet and Approve and Reject links that work straight from your inbox, without signing in. Approve approves as the person the email was sent to, and only the stage the email was about, then opens the timesheet it acted on. If that stage has closed since, or your part of it was decided in your place, nothing is approved and Beebole shows Nothing to approve: this timesheet has moved on since the email was sent. Reject opens the same timesheet with the rejection dialog ready, since a reason is always required. Timesheet reminder emails likewise include a Submit now link when the period already holds entries, so your team can submit a completed period directly from the reminder. You can also decide by replying to the email — the approval email and the approval reminder both end with a note about it:- Reply with approve alone on the first line to approve.
- Reply with reject followed by your reason — on the same line or the lines below — to reject. A reject with no reason changes nothing.
From a phone
On a phone, the approval panes become a bottom sheet. Managers and administrators see a team icon in the header with a badge counting pending approvals; tapping it opens the same Pending and Team tabs, and Approve and Reject sit in the header of a timesheet you may decide, with bulk actions for several at once. The team icon only appears for people who can approve or review timesheets — if all you see are your own tracking controls, your role has no one to review. See Approving team timesheets on mobile.
A submitted week opened on a phone, with Approve and Reject in the header
Rejecting a timesheet
Rejecting always requires an explanation. When you click Reject, a dialog opens with a comment box (Enter a reason for rejection…) — the Reject button stays disabled until you write one. The reason is delivered to the person, by email or push notification following their Approval updates setting, and recorded in their Journal.

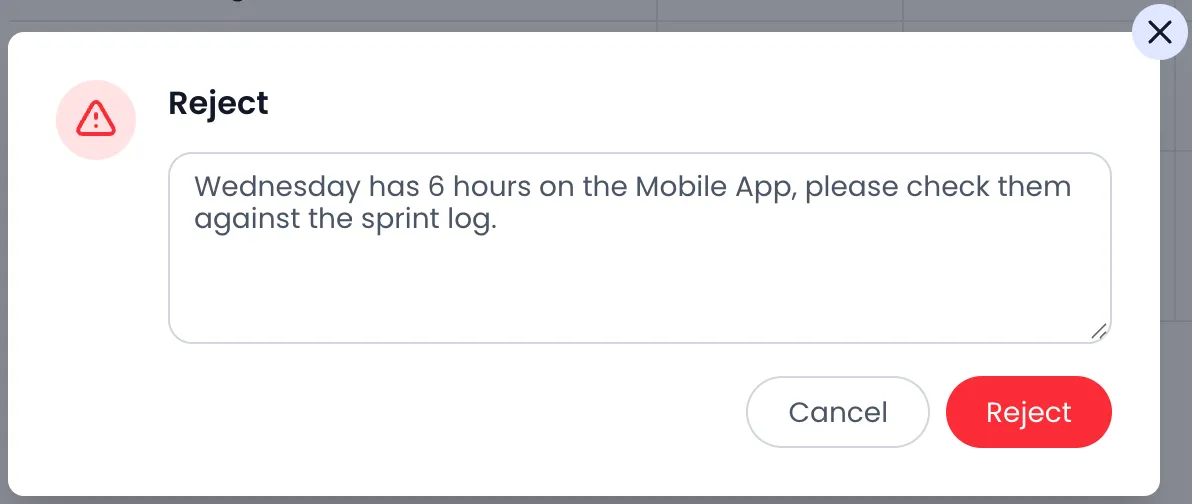

The Reject dialog, with the reason the person receives
Time off approval
Time off goes through the same workflow as work time. When someone records an absence on their timesheet and submits the period, the configured approval stages review it along with the rest of the timesheet. The absence counts against the person’s allowance as soon as it is recorded — approval reviews and locks the entry but does not gate the balance. See Time off for absence types and allowances.Editing a submitted or approved timesheet
Submitting locks a timesheet for its owner, but it doesn’t have to be rejected to be corrected:

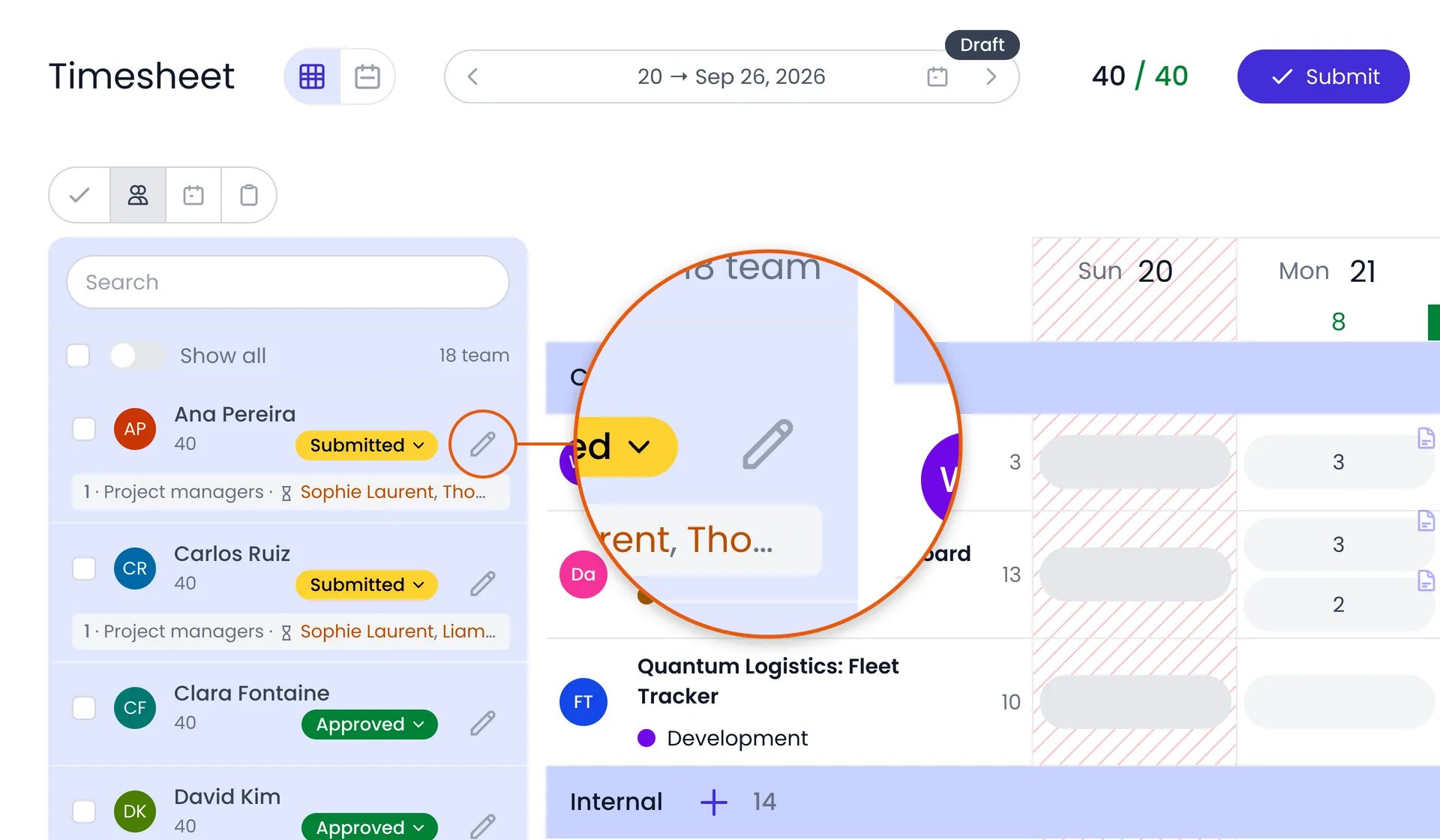

The edit button (Edit timesheet) on a person's row in the Team pane
Stepping in for an approver
When an approver is away, someone above them can unblock the timesheet without reconfiguring the workflow. Anyone above a pending approver in the management chain, whether they manage that approver directly or through a tag or a tag category, at any level, can Approve or Reject the current stage in that approver’s place. An administrator can do it for any approver. This works on every stage type except Admins: only administrators decide an Admins stage. Managers can’t do it on their own timesheet. The timesheets you may decide in an approver’s place show in your Pending pane once Show all is on, with Approve and Reject at the top of the timesheet. You aren’t notified when they are submitted. Approve and Reject appear only to the people allowed to decide, and Beebole refuses a decision from anyone else. Approving twice, or once your part of the stage is done, changes nothing. A decision taken in someone’s place counts only for the approvers it replaces. An administrator who isn’t one of the stage’s approvers decides for all of them. A manager decides only for the pending approvers below them, so a stage with the quorum All still waits for its other approvers. It doesn’t skip the stages after it either: each later stage still needs its own approvers, or someone allowed to decide in their place. The stage breakdown shows the approval as “Ana (by Bob)”, and the person’s Journal says “in place of Ana” (see Approval history). An already-approved timesheet can also be rejected, which sends it back to its owner. An administrator can do it, and so can anyone named on an approval of its last stage, whether they gave it or it was given in their place: for “Ana (by Bob)”, both Ana and Bob. To reach an approved timesheet, open it from the Team pane, not the Pending pane: Pending only lists submissions still waiting for a decision, so an approved period is never there. Pick the person in Team, navigate to the approved period, and Reject appears at the top of their timesheet. Rejecting unlocks the period for its owner, who corrects the entries and clicks Resubmit. To fix an entry without sending the whole period back, use the edit button (Edit timesheet) described above instead.

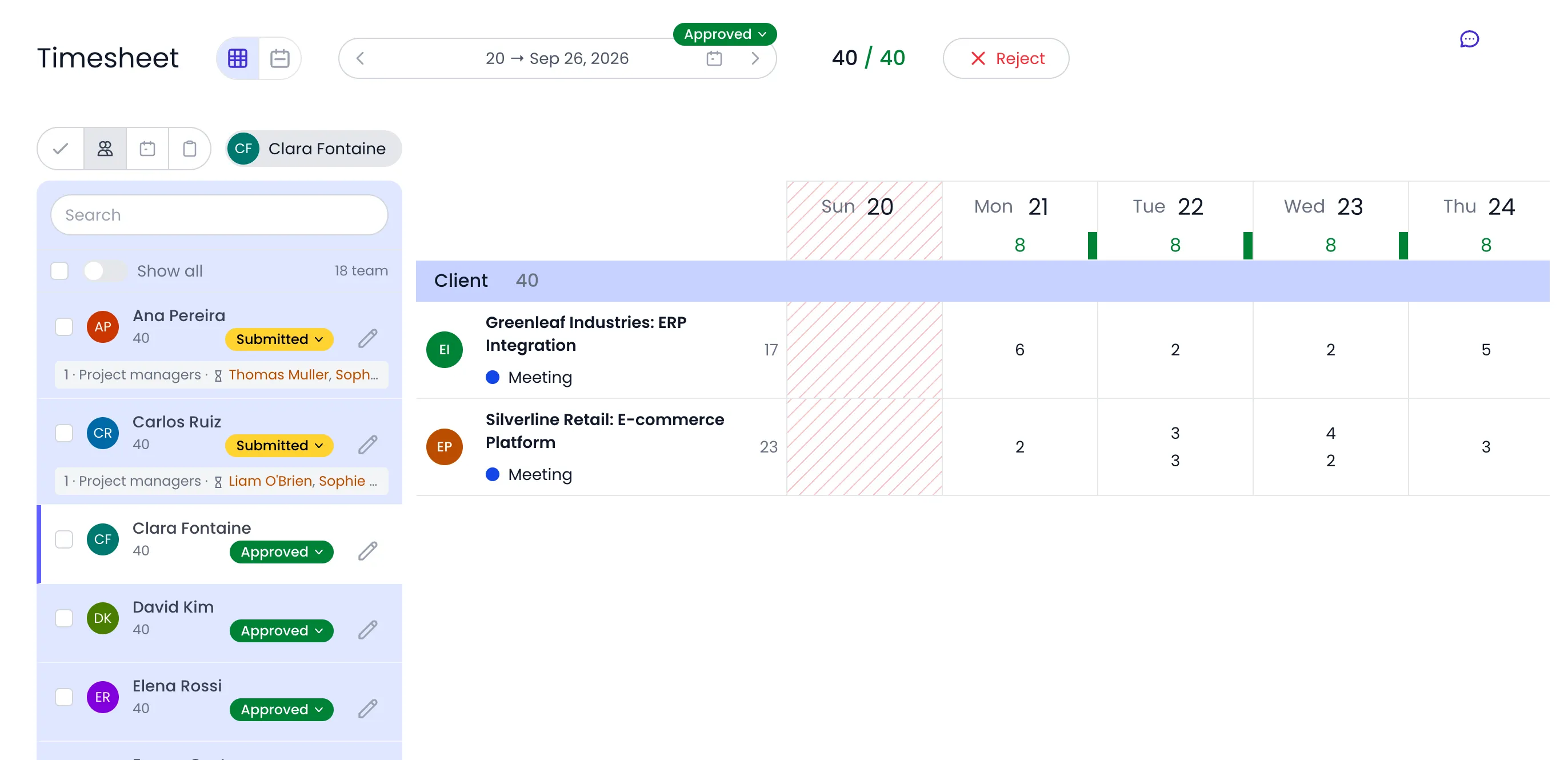

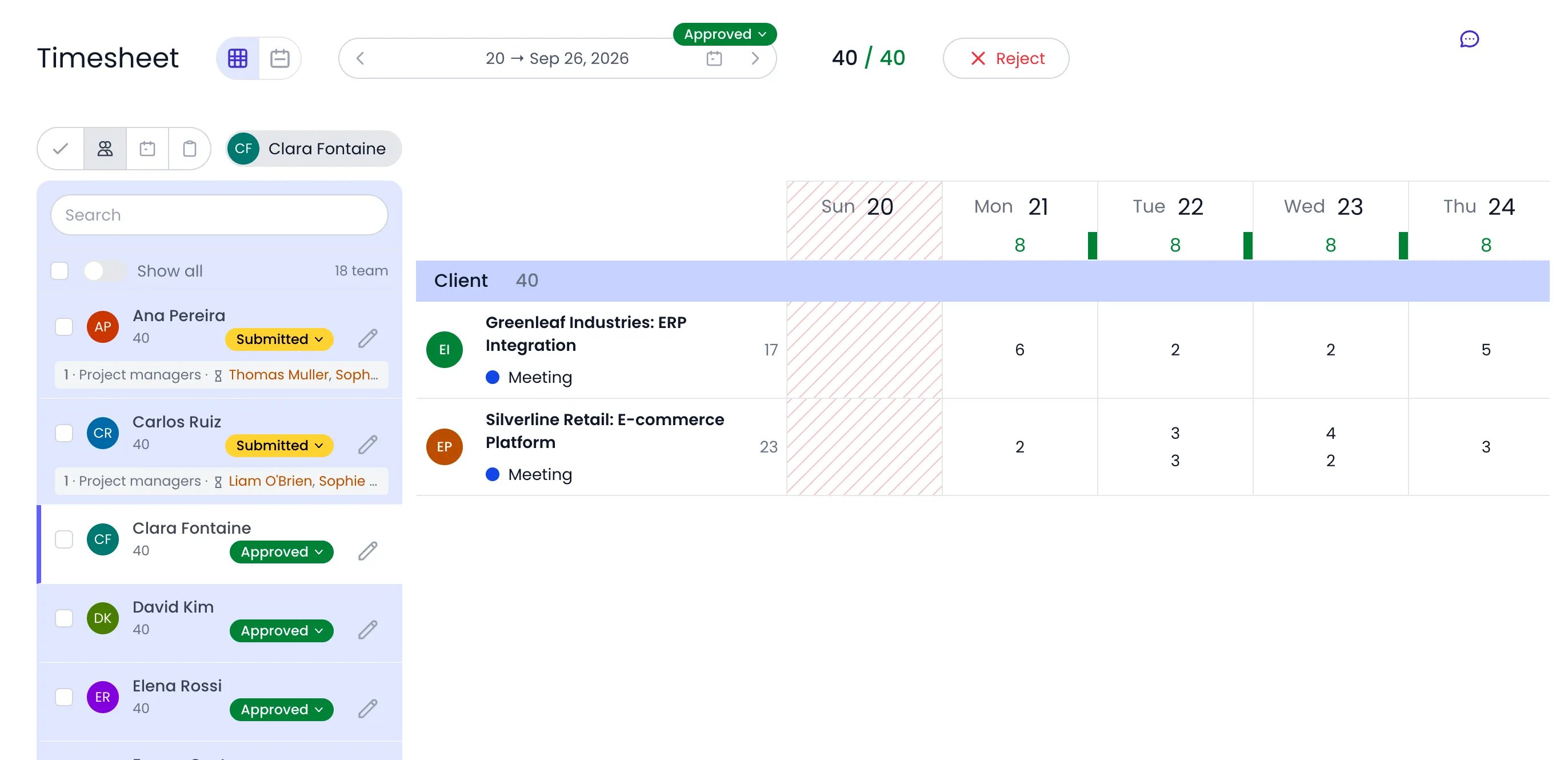

An approved week opened from the Team pane, with Reject at the top
Reminders and notifications
- Remind approvers after a number of days if not yet approved, in the Reminders tab of the Timesheet and Planning Settings panel, automatically follows up on submissions still waiting for review. While a timesheet stays pending, Beebole reminds each pending approver after that many days, then 2, 3, and 4 days after each previous reminder. Five days after the fourth reminder, every administrator gets one too. An approver whose part was decided in their place is no longer reminded. Set it account-wide in Account Settings, or override it on a tag or a person, just like the approval workflow itself.
- The Remind button in the Team pane sends a one-off reminder to people who have an approval workflow and haven’t submitted.
- Each person controls how they receive Approval updates in their notification settings: by email, as push notifications, or both, and instantly or as a digest. Approval updates cover both the timesheets submitted for their approval and the decisions on their own timesheets. See Notifications.
Approval history
Every approval action is logged in the person’s Journal feed: Submitted for approval, Approved by and Rejected by entries with the approver’s name and the rejection reason, plus Auto-submitted and Auto-approved events. An event past the first stage adds its stage, for example “(Stage 2)”. A decision taken in someone’s place adds “in place of” and their name, for example “Approved by Bob in place of Ana”. For who approved what on the current submission, click the timesheet’s status badge to open the stage breakdown, where the same approval reads “Ana (by Bob)”. The person, administrators, and the person’s managers at any level see this whole history. Someone who decided one of the person’s timesheets, themselves or in an approver’s place, sees the events of those periods only.

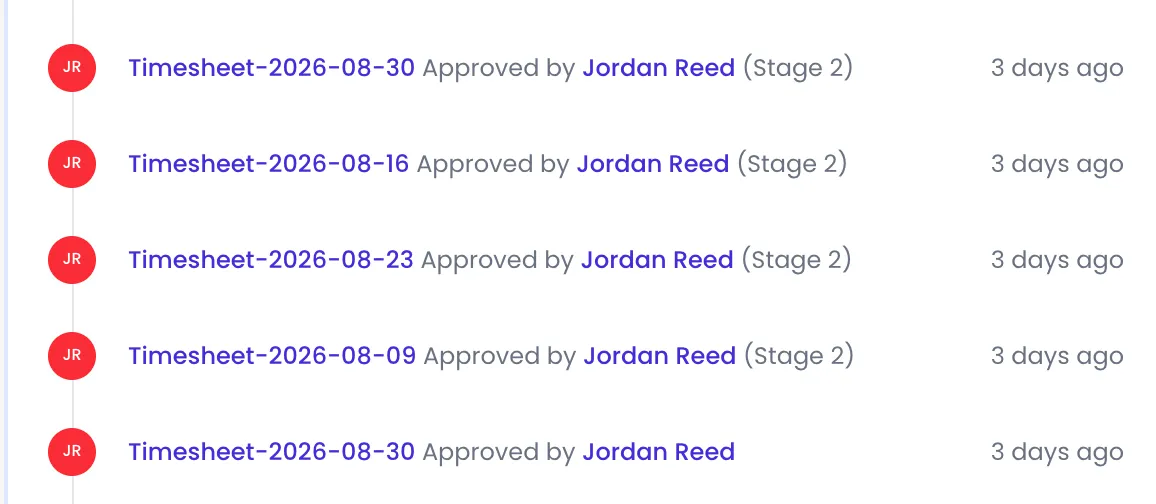

Approval events in a person's Journal
Related content
Timesheets
Timesheet and Planning Settings
Time off
Journal
Frequently asked questions
Can someone else approve while a manager is away?
Can someone else approve while a manager is away?
How do I require only one approval, from the manager or an administrator?
How do I require only one approval, from the manager or an administrator?
What happens if no approval workflow is configured?
What happens if no approval workflow is configured?
How do I reopen an approved timesheet so its owner can edit it?
How do I reopen an approved timesheet so its owner can edit it?
Can I approve timesheets from my phone?
Can I approve timesheets from my phone?
Can I reject a single time entry instead of the whole timesheet?
Can I reject a single time entry instead of the whole timesheet?
